Asset Tracking Pilot Program: How to Test Before Full Rollout

Learn how to run a successful asset tracking pilot program. Reduce implementation risk, refine processes, and gather user feedback before company-wide rollout.

asset-tracking-pilot-program

You've chosen your asset tracking system. You've planned your implementation. You're ready to roll it out to all 500 employees across five locations next Monday.

Stop right there.

I know you're excited. I know leadership wants results yesterday. I know that running an asset tracking pilot program feels like it's slowing you down. But here's the uncomfortable truth I've learned from watching dozens of implementations: the companies that skip the pilot phase spend the next six months fixing problems that a two-week pilot would have caught.

Let me tell you about a manufacturing company I worked with. They skipped the pilot. Rolled out their shiny new asset tracking system to 12 locations simultaneously. Day one, they discovered their warehouse WiFi couldn't handle the scanning app. Day three, they realized their label printer was creating QR codes that wouldn't scan under their fluorescent lighting. Day five, half their users had given up and gone back to clipboards because "the system doesn't work."

Six months and tens of thousands of dollars later, they had a working system. A proper pilot would have cost them two weeks and zero dollars. Understanding the total cost of ownership means accounting for asset tracking implementation risk like this from the start.

Let me show you how to run a pilot that actually works.

Why Pilots Aren't Optional (Even Though Everyone Tries to Skip Them)

I get it. Pilots feel like bureaucracy. Like you're adding steps for the sake of adding steps. But knowing how to test an asset tracking system properly isn't a delay—it's risk mitigation disguised as process.

Here's what a good pilot does:

It reveals technical problems before they become disasters. Does your WiFi actually reach the warehouse corner where you store equipment? Can your servers handle 50 people scanning simultaneously? Do your asset tags survive the environment they'll live in? You'll find out in the pilot, not on rollout day.

It uncovers workflow issues you didn't anticipate. Your process looks perfect on paper. Then someone responsible for managing equipment says "this doesn't work with gloves on" or an IT tech points out "we can't scan laptops while they're docked." Real users find real problems that conference room planning misses.

It gives you a feedback loop before you've committed. If users hate the interface, you can still switch systems. If your tagging strategy is causing problems, you can adjust it. If your data structure is missing critical fields, you can fix it. After full rollout? You're stuck.

It creates champions for your rollout. Pilot users who have input in the process become advocates. They help train others. They defend the system when skeptics complain. They're invaluable during full rollout.

It proves ROI before the big investment. Think of it as an asset tracking proof of concept. Nothing convinces skeptical leadership like "we tested this with the operations team, and they found 23 missing assets in week one." Real results beat PowerPoint slides every time.

I worked with a healthcare organization that wanted to track 3,000 pieces of medical equipment across four hospitals. Their CFO was skeptical about the $30,000 investment. We ran a one-month pilot in a single department—radiology. They found $18,000 worth of equipment that was "lost" and reduced equipment search time by 40%.

The CFO approved the full rollout the next day.

Choosing Your Pilot: Department, Location, or Both?

You can't pilot "a little bit of everything." That's not a pilot—that's a half-baked rollout. To properly test asset tracking software, you need a clearly defined scope that's representative enough to validate your assumptions but small enough to manage.

Option 1: Single Department, All Locations

What it looks like: Track all IT equipment company-wide, but only IT equipment.

When it works:

  • You have standardized processes across locations
  • One asset category has unique requirements (like IT or vehicles)
  • You want to test cross-location workflows

Potential issue: You won't test how the system handles asset variety. Office furniture behaves differently than power tools.

Option 2: Single Location, All Asset Types

What it looks like: Roll out everything at your headquarters but nowhere else.

When it works:

  • Locations have very different characteristics (office vs. warehouse vs. job site)
  • You want to test the full range of asset types
  • One location is particularly tech-savvy or willing to experiment

Potential issue: You might not catch location-specific problems (like the warehouse WiFi issue I mentioned).

Option 3: The Hybrid Approach (My Favorite)

What it looks like: Choose one representative location and 2-3 asset categories that cover different use cases.

Example: Headquarters office + IT equipment + office furniture + tools

Why this works: You get variety in asset types (expensive/cheap, mobile/stationary, frequently transferred/rarely moved) without overwhelming scope. This hybrid approach is the most effective pilot program for asset management across industries—whether you're managing church and non-profit assets or property management equipment.

What Makes a Good Pilot Location?

Pick a location that's:

  • Representative of your broader organization (not your easiest or your hardest)
  • Accessible for troubleshooting and observation
  • Medium-sized (big enough to surface issues, small enough to manage)
  • Willing to participate (resistant pilot users doom the project)

Don't pick:

  • Your smallest, simplest location (it won't reveal real-world complexity)
  • Your most chaotic location (you'll just create frustration)
  • Remote locations where you can't provide hands-on support
  • Locations facing major disruptions (moves, reorganizations, etc.)

How Many Assets Should You Include?

Here's my rule of thumb:

Company SizePilot Asset CountPilot Users
<500 total assets50-100 assets5-10 users
500-2,000 total assets100-300 assets10-20 users
2,000-10,000 total assets300-500 assets20-40 users
>10,000 total assets500-1,000 assets40-80 users

The minimum viable pilot: At least 50 assets and 5 active users. Anything smaller doesn't generate enough activity to test real workflows.

The maximum manageable pilot: No more than 10% of your total assets. Beyond that, you're basically doing a full rollout with a different name.

Defining Your Pilot Scope: The Details That Matter

Vague pilot scopes lead to vague results. "Let's try it and see what happens" isn't a plan. Here's what you need to define explicitly:

What You're Testing

Be specific about scope:

  • Asset categories included: (e.g., laptops, monitors, desks, office chairs—but not vehicles or manufacturing equipment)
  • Asset categories excluded: (explicitly list what you're NOT tracking)
  • Location boundaries: (Building A, floors 1-3, including storage room but not data center)
  • User groups: (IT team, facilities team, office managers—but not general employees)

What You're Measuring

Define success criteria upfront (more on this in the metrics section):

  • Time to locate assets
  • Asset accountability rate
  • User adoption rate
  • Data entry error rate
  • Time spent on asset-related tasks

What Processes You're Testing

Don't just test the software—test your entire workflow:

  • New asset intake (how equipment enters the system)
  • Asset tagging process (who does it, when, with what materials)
  • Check-out/check-in procedures
  • Transfer workflows
  • Disposal recording
  • Audit processes (yes, audit during the pilot)

What You're NOT Testing Yet

Be clear about what's out of scope:

  • Integration with other systems (save for full rollout)
  • Complex reporting (focus on core functionality)
  • Advanced features you won't use immediately
  • Customizations you're not sure you need

This prevents scope creep. "While we're at it, let's also..." is how pilots turn into sprawling messes. If you're starting from scratch and currently using spreadsheets, check out our guide on transitioning from spreadsheets to asset tracking software.

Timeline: How Long Should a Pilot Actually Run?

Everyone wants to know: how long? Based on pilot testing best practices, here's what I recommend.

Too short (less than 2 weeks): You catch the obvious technical issues but miss the workflow problems that emerge over time. You don't see how data quality degrades. Users don't build real habits.

Too long (more than 3 months): Momentum dies. People forget it's a pilot and treat it like permanent but broken. Leadership loses patience.

The sweet spot: 4-8 weeks for most organizations.

Week 1-2: Setup and Initial Use

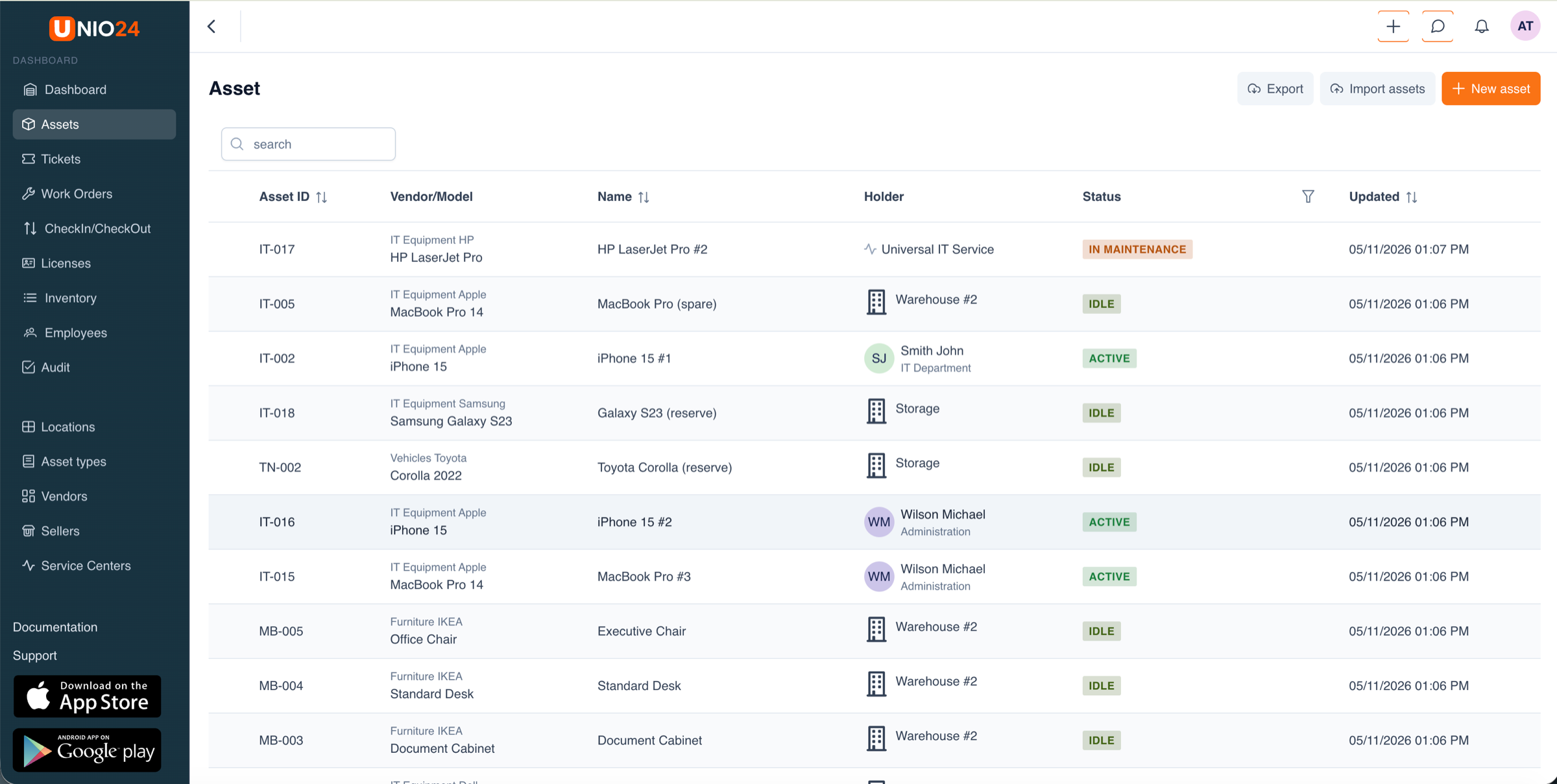

  • Configure system
  • Tag pilot assets (see our asset tagging guide)
  • Import or enter initial data
  • Train pilot users
  • Start using the system for real work

What you're watching for: Technical issues, basic usability problems, "this button doesn't work" type feedback.

Week 3-5: Real-World Testing

  • System is in daily use
  • Users are performing actual workflows
  • Early process issues become apparent
  • You start seeing which features get used and which get ignored

What you're watching for: Workflow friction, missing features, training gaps, data quality issues.

Week 6-8: Evaluation and Refinement

  • Gather formal feedback
  • Analyze usage data
  • Test any adjustments you made
  • Run a mini-audit to check data quality
  • Make go/no-go decision

What you're watching for: Whether improvements stick, whether users would recommend it, whether the system solves your actual problems.

Accelerated Pilot (2-3 weeks)

Sometimes you genuinely need speed. Maybe your annual audit is in six weeks. Maybe you're under regulatory pressure. You can run a compressed asset tracking trial:

Week 1: Intensive setup, training, and initial testing Week 2: Full operational use with daily check-ins Week 3: Rapid feedback collection and decision

Warning: This only works if you have dedicated resources, experienced implementation lead, and simple requirements. For complex environments, don't rush it.

Success Metrics: Measuring What Actually Matters

"Did the pilot work?" is a terrible question. You need specific, measurable asset tracking evaluation criteria decided before the pilot starts. Here's what actually matters—and what the numbers should look like.

Technical Performance: Does It Actually Work?

Your system needs to be reliable, period. Aim for 99%+ uptime during the pilot—if users regularly can't access the system, you've already lost. Mobile app performance matters more than you think: scanning should take under 3 seconds from QR code to asset details. Any slower, and users will find excuses not to scan.

Data sync reliability is your hidden killer. Track whether offline scans sync successfully when users get back online. Lost scans mean lost data, and lost data means lost user trust. You don't recover from that easily.

User Adoption: Are People Actually Using It?

The numbers don't lie. You want 80%+ of pilot users actively using the system weekly. Track logins and transactions per user—if half your pilot users aren't engaging, your full rollout will crash and burn.

Process compliance tells you if the system fits the workflow. Are 90%+ of asset transfers actually being recorded? Compare what happens physically to what gets logged in the system. If people are working around it, your process is broken—fix it now, not during rollout.

Time to competency is the key metric of asset tracking user acceptance testing. Users should perform basic tasks independently within 2 days. If they still need hand-holding after week one, something's wrong with either the interface or your training approach.

Business Impact: Is This Worth It?

Here's where you prove ROI. Time to locate assets should drop by at least 50%—ask users to estimate before and after. If the system doesn't make finding things faster, what's the point?

Asset accountability is your accountability check: 95%+ of pilot assets should have a known location and custodian. Run an audit at the end of the pilot to verify. If you can't account for assets after the pilot, you won't be able to after rollout either.

Data accuracy needs to hit 95%—meaning location, status, and assignment match reality when you physically verify. Garbage data in the pilot means garbage data in production. Also track found/recovered assets during the pilot. Discovering even a few "missing" items proves immediate value and helps sell the rollout.

User Satisfaction: Will They Recommend It?

This is your truth check. At least 70% of pilot users should recommend company-wide rollout. If your most enthusiastic early adopters don't recommend it, you have serious problems to fix.

Perceived ease of use should average 4+ out of 5 on surveys. If users find it difficult, they won't use it long-term—no matter how good the features are. And perceived value matters most: users need to believe it solves a real problem. Listen for phrases like "this helps me do my job better." If they see it as busywork instead of a helpful tool, you have a change management problem that no amount of training will fix.

Gathering Feedback: The Right Questions at the Right Time

Don't wait until the end of the pilot to ask "how's it going?" By then, frustrated users have mentally checked out. You need continuous feedback loops. Avoiding this mistake is crucial—read about other common asset management mistakes to watch out for.

Week 1: Daily Check-Ins

During the first week, have quick 5-minute conversations or Slack check-ins every day. Ask what's confusing, where people are getting stuck, what's taking longer than it should, and whether they're seeing errors or bugs. Daily feedback is critical here because technical issues and initial usability problems need immediate attention. A confusing button that wastes 30 seconds per scan will waste 500 minutes over the pilot. Fix it now.

Week 2-3: Weekly Surveys

Switch to short weekly surveys—5 questions max, takes 2 minutes. Ask users to rate ease of use on a 1-5 scale, identify which task took the most time this week, suggest what they'd change if they could, and request any features they wish existed. Include an open comment box for things you didn't think to ask about.

Weekly surveys let you see trends emerge. If three people independently request the same feature, it matters. If nobody mentions last week's complaint, you fixed it. This rhythm keeps you connected without overwhelming pilot users.

Week 4-6: Structured Interviews

Now dig deeper with 15-30 minute one-on-one conversations with representative users. Have them walk you through their typical asset workflow. Ask where the system helps and where it gets in the way. Find out if they're more or less productive with this system, whether they'd want to keep using it, and what would make it excellent instead of just okay.

Surveys give you data. Interviews give you understanding. You learn why something is a problem, not just that it is. The stories users tell in interviews reveal the context that survey checkboxes miss.

End of Pilot: Comprehensive Feedback

Finish with a final survey plus a group debrief session. The survey should cover overall satisfaction (1-10 scale), whether they'd recommend company-wide rollout, their top 3 things that work well, top 3 things that need improvement, and any concerns about wider rollout.

The group debrief is where magic happens. Gather pilot users together and let them talk to each other, not just to you. The conversations they have—comparing experiences, debating solutions, building on each other's ideas—reveal insights surveys will never capture.

The Question You Must Ask (But Might Be Afraid To)

"If we rolled this out company-wide tomorrow, would you be excited or would you be worried?"

This question cuts through politeness and reveals real sentiment. If pilot users—your early adopters, your most favorable audience—are worried about rollout, you're not ready.

Common Issues Discovered in Pilots (and How to Fix Them)

Let me save you some trouble by sharing the issues that show up in almost every pilot I've seen—and what to do about them.

Issue 1: "The WiFi Doesn't Reach"

What happens: Users can't scan assets in certain areas because there's no network connection.

Why it matters: If scanning doesn't work where the assets actually are, the system is useless.

The fix: Test whether your mobile app has offline mode (most modern ones do). If WiFi coverage is genuinely important, add access points to problem areas. For truly remote locations, consider cellular-enabled devices. Or simply accept that some areas will require an offline-then-sync workflow—it's not ideal, but it works.

Lesson: Always test in the actual physical environment, not just the office. WiFi maps lie.

Issue 2: "This Takes Too Long"

What happens: Users complain that recording an asset transfer takes 5 minutes when it should take 30 seconds.

Why it matters: If your process is slower than the old way, adoption will fail.

The fix: Identify exactly which steps are slow—don't assume you know. Remove unnecessary form fields (do you really need all 15 fields for a simple transfer?). Enable bulk actions so users can transfer 10 items at once instead of one-by-one. Create templates for common transactions. And use scanning instead of typing whenever possible.

Lesson: Time every workflow with a stopwatch. If routine tasks take more than 3 clicks and 30 seconds, simplify until they don't.

Issue 3: "Labels Keep Falling Off"

What happens: Asset tags don't survive the environment. They peel, fade, or become unreadable.

Why it matters: If you can't scan the tag, you can't track the asset. All that tagging effort was wasted.

The fix: Test label durability in actual conditions during the pilot—stick a tag on equipment and see what happens after two weeks. Switch to more durable materials if needed: polyester instead of paper, metal tags for harsh environments. Improve your surface prep before labeling (clean, dry surfaces make a huge difference). Use protective laminate for outdoor or high-traffic items. Or consider NFC tags for metal surfaces or harsh conditions where printed codes won't survive.

Lesson: For detailed guidance on choosing the right labels for your environment, see our asset tagging best practices guide. What works in an air-conditioned office won't survive in a warehouse or outdoor environment. Learn more about QR code vs NFC vs RFID technologies for different use cases.

Issue 4: "I Don't Know Where to Put the Category"

What happens: Users struggle to categorize assets. "Is a wireless keyboard IT Equipment or Office Supplies?"

Why it matters: Inconsistent categorization destroys your reporting and makes searching difficult.

The fix: Create a simple decision tree: "If it plugs in → IT Equipment. If you sit on it → Furniture. If it has a motor → Equipment." Reduce the number of categories—10 is better than 47. Provide examples for each category so users have reference points. Allow users to flag "I'm not sure" for review instead of forcing them to guess wrong. And spend specific time training on categorization—it's not intuitive.

Lesson: Your category structure makes perfect sense to you. It's confusing to everyone else. Simplify ruthlessly.

Issue 5: "Nobody Told Me I Had to Do This"

What happens: Pilot users don't understand they're supposed to actively use the system, not just let it exist.

Why it matters: Passive participation doesn't test anything. You need real usage.

The fix: Set crystal-clear expectations at pilot kickoff—don't assume people know what "participating in a pilot" means. Send weekly reminders of what pilot activities they should be doing. Make participation part of pilot users' actual job responsibilities during the pilot period, not something they squeeze in when convenient. Designate a pilot coordinator who checks in regularly to keep momentum going. And celebrate participation, not just results—people need to know their engagement matters.

Lesson: Communicate expectations explicitly, repeatedly, and clearly. What's obvious to you isn't obvious to them.

Issue 6: "The Data Was Wrong From Day One"

What happens: You import existing data without cleaning it first. Pilot starts with garbage data. Users immediately lose trust.

Why it matters: You can't test data quality improvement if you start with bad data.

The fix: Clean your data before pilot launch—see our data migration guide for how. Verify a sample of records before importing everything. Run a mini-audit during week one to catch errors early while they're still manageable. And be transparent with pilot users: "We know some data is wrong—help us find and fix it" builds collaboration instead of frustration.

Lesson: Garbage in, garbage out. There are no exceptions to this rule.

Scaling Lessons: What Works in Pilot Won't Always Work at Scale

Here's the trap: your pilot succeeds brilliantly. You have 20 engaged users, excellent data quality, and glowing feedback. You roll out to 500 users and... it falls apart.

Why? Because small-scale and large-scale are different games.

The "I'll Just Ask Bob" Problem

In pilot: When someone has a question, they ask Bob (the implementation lead). Bob answers immediately. Problem solved.

At scale: 500 people can't all ask Bob. Bob drowns. Response times go from 5 minutes to 5 days. Users get frustrated and give up.

The fix: Build self-service support before rollout. Create searchable documentation with screenshots. Build an FAQ based on actual pilot questions. Record video tutorials for common tasks (people watch videos when they won't read manuals). Train department champions who can answer basic questions in their areas. And establish a clear escalation path for complex issues so people know where to go when the champion can't help.

The "Everyone's Motivated" Problem

In pilot: Pilot users volunteered or were specially selected. They're motivated to make it work. They forgive small issues. They actively provide feedback.

At scale: Most users didn't ask for this. They have their own work to do. They won't forgive issues. They won't provide feedback—they'll just stop using it.

The fix: Address all significant pain points before rollout—don't assume people will be forgiving like your pilot users were. Communicate the "why" clearly and repeatedly so people understand the value, not just the work. Make adoption as easy as possible by reducing every point of friction you can. And provide incentives or recognition for good adoption; people respond to positive reinforcement.

The "We Can Check Everything" Problem

In pilot: With 50 assets, you can manually verify data quality weekly. You catch errors fast.

At scale: With 5,000 assets, manual verification is impossible. Errors accumulate. Data quality declines.

The fix: Build automated data quality checks that flag assets with no location, duplicate serial numbers, or other obvious problems. Implement a sustainable audit strategy with cycle counting instead of hoping annual audits will catch everything. Create accountability by making data quality someone's actual job responsibility—if it's everyone's job, it's no one's job. Set quality metrics and review them monthly to catch degradation early.

The "Bob Does It All" Problem

In pilot: Bob configures the system, trains users, handles imports, fixes errors, and responds to questions. It works because the scope is small.

At scale: Bob can't do it all. Bottlenecks emerge everywhere.

The fix: Document everything Bob knows—do this before rollout, while he still has time to write things down. Train additional administrators so knowledge isn't concentrated in one person. Delegate responsibilities clearly: one person for training, one for data quality, one for technical support. Create clear roles and ownership so everyone knows who does what.

The "It Only Takes 5 Minutes" Problem

In pilot: Adding a new asset takes 5 minutes. No big deal.

At scale: You're adding 50 new assets per week. That's 250 minutes = 4+ hours of work. Suddenly it's a big deal.

The fix: Streamline data entry with fewer required fields and smart defaults. Enable bulk import so you can add 20 similar laptops at once instead of individually. Integrate with procurement to auto-create assets from purchase orders. And assign data entry responsibility clearly—don't let it fall through the cracks between departments.

The lesson: Always multiply pilot effort by your scale factor. If something takes 1 hour per week in pilot, it'll take 25 hours per week at 25x scale. Plan accordingly.

Making the Go/No-Go Decision

Your pilot is complete. You have data, feedback, and experiences. Now comes the moment of truth: do you proceed with full rollout, or do you stop and reconsider?

This decision should be based on evidence, not politics or sunk costs. Here's a framework:

Automatic "Go" Criteria

If all of these are true, proceed with confidence: technical performance meets targets (>99% uptime, fast scanning), user adoption exceeds 80%, data accuracy exceeds 95%, at least 70% of users would recommend rollout, you've discovered no showstopper issues, and ROI is demonstrable through time saved, assets found, or efficiency gained.

When you hit these numbers, proceed to full rollout. Celebrate the pilot success. Use pilot users as champions to help with training and advocacy during rollout.

Automatic "No-Go" Criteria

If any of these are true, do not proceed: the system is regularly unavailable or unreliable, users actively resist or work around the system, critical workflows are broken or impossible, data quality is worse than before the pilot, leadership or budget approval has evaporated, or the vendor shows inability to fix critical issues.

When you see these red flags, stop. Either fix the fundamental problems, choose a different asset tracking system, or reconsider your approach entirely. Don't push forward hoping it'll get better—it won't.

The Gray Zone: "Go with Modifications"

Most pilots land here. Things mostly work, but there are significant issues to address.

What it looks like:

  • Technical performance is acceptable but not great
  • User adoption is 60-75% (good but not excellent)
  • Some workflow pain points discovered
  • Users see value but have reservations
  • Data quality is improving but not there yet

Questions to ask:

  1. Are the issues fixable? (Technical problems usually are; fundamental workflow mismatches often aren't)
  2. How long will fixes take? (2 weeks is reasonable; 6 months means you're not ready)
  3. Will fixes address user concerns? (Ask them, don't assume)
  4. Can you afford to wait? (Sometimes external pressure forces suboptimal timing)

Action: Fix the top 3-5 issues identified in pilot. Run a mini-pilot (2 weeks) to test fixes. Then make a final go/no-go decision.

The Scorecard Approach

Create a simple scorecard to quantify the decision:

CriteriaWeightScore (1-10)Weighted Score
Technical performance20%81.6
User adoption25%71.75
Data quality20%91.8
User satisfaction15%60.9
Business impact20%81.6
Total100%-7.65

Scoring:

  • 8-10: Green light, proceed with rollout
  • 6-7.9: Yellow light, address issues then proceed
  • Below 6: Red light, significant rework needed

Adjust weights based on what matters most to your organization. If user satisfaction is critical for your culture, give it 30%. If technical reliability is paramount, weight it higher.

Communicating Pilot Results

Your pilot is done. You've made your go/no-go decision. Now you need to communicate results to stakeholders—leadership, future users, and the broader organization.

The Executive Summary (For Leadership)

Keep it to one page. Executives don't have time for 40-page reports.

Include:

  1. Pilot overview: What you tested, when, with whom
  2. Key metrics: User adoption, data accuracy, time savings (use numbers)
  3. Success stories: Specific examples of value ("found $12,000 in missing equipment")
  4. Issues discovered and resolved: Show you identified and fixed problems
  5. Remaining risks: Be honest about what concerns remain
  6. Recommendation: Clear go/no-go with supporting rationale
  7. Next steps: Timeline and resource requirements for rollout

Pro tip: Lead with results, not process. "Pilot users reduced equipment search time by 60%" not "We completed all pilot activities on schedule."

The Detailed Report (For Implementation Team)

This is your institutional knowledge. Document everything.

Include:

  • Complete pilot scope and timeline
  • User roster and participation rates
  • All feedback collected (organized by theme)
  • Technical issues discovered and their resolutions
  • Process changes made during pilot
  • Before/after comparisons with data
  • Lessons learned (what worked, what didn't)
  • Recommendations for full rollout
  • Appendices: surveys, interview notes, metrics data

Why this matters: Six months from now, when you're troubleshooting a rollout issue, this document is gold. One year from now, when you're piloting a different system, this is your playbook.

The Announcement (For Future Users)

If you're proceeding to rollout, the announcement sets expectations and builds enthusiasm.

Share the pilot results concretely: "We tested this with the IT and Operations teams for 6 weeks." Highlight what worked: "Users found equipment 60% faster and we located $15,000 in missing assets." Show that you listened to feedback: "Based on what we learned, we simplified the transfer process and added offline mode." Set clear expectations: "You'll receive training 2 weeks before your department goes live." And connect to benefits they actually care about: "Spend less time searching, more time on actual work."

Keep the tone confident but not dismissive of concerns. "We know change is hard. We tested this thoroughly and it works" is much better than "This is going to be great!" without backing it up.

Using Pilot Users as Champions

Your pilot users are your most valuable asset during rollout. They've used the system. They know it works. They can answer peer questions with credibility.

Feature their testimonials in announcements—real quotes from real users carry weight. Have them co-lead training sessions for their departments; peer-to-peer training is more credible than top-down instruction. Designate them as "go-to" people for questions in their areas. And recognize their contribution publicly—people appreciate being valued, and it encourages others to engage positively with the rollout.

What one pilot user told me: "I was skeptical at first. But once I saw how much time it saved finding equipment, I was sold. Now I'm helping train the rest of the team."

That testimonial is worth more than any executive memo.

Real Case Study: A Pilot That Saved a Rollout

Let me share a real example where the pilot proved its worth (details anonymized).

Company: Regional education services organizationAssets: ~800 items (laptops, projectors, vehicles, facilities equipment) Initial plan: Roll out to all 7 locations simultaneously in January

The Pilot

Scope: Main office + IT equipment + facilities equipment (200 assets, 15 users) Duration: 6 weeks (October-November)

Week 1-2: Rocky Start

Problems discovered:

  • QR code labels didn't adhere well to textured laptop cases
  • WiFi in storage areas was spotty
  • Asset transfer workflow required 8 form fields, but users only knew 3 of them
  • Mobile app crashed when scanning in quick succession

Immediate fixes:

  • Switched to vinyl labels with stronger adhesive
  • Enabled offline mode in mobile app (sync when back in WiFi)
  • Made 5 form fields optional with reasonable defaults
  • Vendor pushed app update within 5 days (crashing was a known bug)

Week 3-4: Steady Improvement

Feedback themes:

  • "Much faster than the old spreadsheet"
  • "I like that I can see who has equipment from my phone"
  • "I wish I could scan multiple items at once for bulk transfers"

Actions taken:

  • Vendor confirmed bulk scanning was coming in next release (2 weeks out)
  • Adjusted training to emphasize mobile app benefits
  • Created quick reference cards based on actual user questions

Week 5-6: Evaluation

Metrics:

  • 93% user adoption (14 of 15 users actively scanning)
  • 96% data accuracy (physical audit matched system records)
  • Time to locate assets: reduced from average 15 minutes to 3 minutes
  • Assets found that were previously "missing": 7 items worth $4,300

User satisfaction: 86% would recommend rollout

The Critical Discovery:

During the pilot, they attempted to integrate with their accounting system (to pull purchase dates and costs). The integration worked—but it was importing data in a format that didn't match their asset categories.

Result: 40% of imported assets had wrong category assignments. Users spent hours manually correcting them.

If they'd discovered this during full rollout across 7 locations and 800 assets? Chaos. Frustrated users. Data quality disaster. This is exactly the kind of problem our data migration and cleansing guide helps you avoid.

Because they discovered it in the pilot? They fixed the import mapping before any large-scale data migration. Full rollout had clean data from day one.

The Go Decision

Based on pilot results, they decided:

  • ✅ Proceed with full rollout
  • Delay rollout by 3 weeks to: implement bulk scanning feature, refine import process, create better documentation based on pilot questions
  • Change rollout approach: Use a phased rollout for asset tracking—2 locations per month instead of all at once (reduces support burden, allows learning between waves)

The Rollout Results

Six months after full rollout:

  • 94% user adoption across all locations
  • Equipment search time reduced by 70% company-wide
  • Annual audit completed in 3 days instead of 11 days
  • Zero "I didn't know we had this system" complaints (because communication was strong)

What the IT Director said: "The pilot was the best decision we made. We found and fixed so many issues that would've derailed the rollout. The three-week delay we took to address pilot findings saved us months of cleanup later."

The Lesson

The pilot added 6 weeks to their timeline. It probably added 40 hours of work. But it prevented a disaster and ensured rollout success.

That's the whole point.

Your Pilot Checklist

Ready to run your pilot? Here's your asset tracking go-live checklist—step by step:

4-6 Weeks Before Pilot

  • Define pilot scope (departments, locations, asset categories)
  • Choose pilot users (willing, representative, accessible)
  • Set success criteria and metrics
  • Schedule pilot timeline (start date, end date, evaluation period)
  • Communicate pilot plan to leadership and pilot users

2-3 Weeks Before Pilot

  • Configure system for pilot environment
  • Prepare asset tags and labels
  • Clean and prepare data for import
  • Create training materials
  • Set up feedback collection tools (surveys, interview schedule)

Week Before Pilot

  • Tag pilot assets
  • Import initial data and verify accuracy
  • Train pilot users (hands-on, interactive)
  • Distribute quick reference guides
  • Set up support channels (Slack, email, etc.)

During Pilot

  • Daily check-ins (first week)
  • Weekly surveys (ongoing)
  • Address technical issues immediately
  • Document all feedback and issues
  • Make quick-win adjustments as you go
  • Track usage metrics continuously

End of Pilot

  • Conduct final user survey
  • Schedule user interviews or group debrief
  • Run physical audit to verify data accuracy
  • Calculate all success metrics
  • Analyze what worked and what didn't

Post-Pilot

  • Create executive summary of results
  • Write detailed pilot report
  • Make go/no-go decision using scorecard
  • If "go": create rollout plan based on lessons learned
  • If "no-go" or "go with modifications": document required fixes
  • Communicate results to all stakeholders
  • Thank and recognize pilot users

Final Thoughts: The Pilot That Almost Didn't Happen

I'll leave you with this story.

A logistics company came to me wanting to implement asset tracking. They had the budget. They had leadership buy-in. They wanted to start rolling out next week.

I suggested a pilot. The COO pushed back: "We don't have time for a pilot. We need this working now. Our auditors are coming in three months."

I said: "You're right, you don't have time for a full rollout to fail because you skipped testing."

Reluctantly, they agreed to a three-week asset management pilot project. One location. 150 assets. 12 users.

Week one, they discovered:

  • Their mobile scanners couldn't read the QR codes they'd chosen (wrong format)
  • Their receiving process required information that purchasing wasn't providing
  • Their location layout meant assets moved between zones constantly, breaking their planned location structure

They fixed all three issues during the pilot.

When they rolled out to all six locations, it went smoothly. No surprises. No major issues. Users were trained by pilot participants who'd already solved the common problems.

The auditors came. The audit went perfectly. They had clean, accurate data.

The COO told me later: "That three-week pilot saved us three months of firefighting. Best delay we ever had."

And that's the point of a pilot. Not to slow you down—to keep you from having to do it twice.

So yeah, run the pilot. Test the assumptions. Find the problems. Fix them while they're small.

Your future self will thank you.


How UNIO24 Makes Pilots Actually Simple

UNIO24 is built specifically to help you avoid the common pilot problems described in this article. We've designed the platform with pilots in mind—because we know that's where implementation success is won or lost.

Start with up to 50 assets completely free—no credit card, no commitment, no pressure. But if your pilot needs more scope, we're ready to discuss extending the asset limit for your pilot project. Every organization is different, and we want you to test in a way that actually validates your use case.

UNIO24 Mobile works offline from day one, so you won't face the "WiFi doesn't reach" problem. Scanning is fast—under 2 seconds from QR code to asset details. QR codes and NFC tags work right out of the box, no special hardware needed. The interface is simple enough that pilot users are productive within hours, not weeks, so you'll quickly see whether your team will actually adopt it.

We don't just provide software—we help you run your pilot. Our team has experience with hundreds of pilot programs across different industries. We can help you define scope, set success metrics, structure your feedback collection, and interpret your results. You're not navigating this alone.

Tag your pilot assets, import your data, train your users, and see how it works in your actual environment—with support from people who've done this before.

Run your pilot. Gather real feedback. Make a confident decision based on real results, not vendor promises.

Ready to test before you commit? Start your free pilot with UNIO24 today or contact us to discuss a custom pilot scope for your organization.
